The Long Term Vision and Plan for the Parliamentary Precinct: Annual Report 2024 to 2025

On this page

Message from the Assistant Deputy Minister of Public Services and Procurement

It is my privilege to present the 2024 to 2025 Annual Report for the Long Term Vision and Plan (LTVP), which chronicles a year of remarkable progress in transforming Canada's Parliamentary Precinct. This ongoing renewal is not only preserving our nation's most iconic heritage buildings, but also ensuring they are ready to serve Parliament and Canadians for generations to come.

Strategic vision and endorsement

This year, we reached a historic milestone with the completion of the first major update to the LTVP in nearly 2 decades. The updated Plan sets out a flexible, forward-looking framework to create a modern, integrated, and secure parliamentary campus. Formal endorsement from the Senate of Canada was secured, and we look forward to seeking endorsement from the House of Commons and Cabinet in the coming year. Once approved, the updated Plan will be published for all Canadians to see.

Economic impact and investments

Our investments—now totaling nearly $5.9 billion to date and creating more than 89,000 jobs—continue to deliver strong economic benefits, supporting high-quality jobs in skilled trades, construction, engineering, architecture, and manufacturing. In 2024 to 2025, program expenditures reached $562.5 million and drove significant progress on projects that are not only revitalizing the heart of our democracy, but also supporting Canada's industrial base and promoting domestic resilience by prioritizing Canadian materials.

Centre Block Rehabilitation Program

The rehabilitation of Centre Block, the largest and most complex project of its kind in Canada, continues to set new benchmarks for modernization and restoration. This year, the project finalized the landscape design, advancing a vision for a welcoming and accessible national gathering place. Construction efforts focused on structural upgrades such as installing support posts, temporary roof enclosures for the Centre Block and the tower cranes, which marks the start of the Parliament Welcome Centre structural build.

Block 2 redevelopment

The redevelopment of Block 2 is a transformative project completing the fourth wall of Canada's parliamentary square. It is shaping the future of parliamentary accommodations for the Senate and House of Commons. In 2024 to 2025, 50% schematic design was completed, with 90% targeted by the end of 2025. Construction also mobilized with a focus on site services and demolition.

Strategic property acquisitions

To support Parliament's long-term accommodation needs, Public Services and Procurement Canada (PSPC) acquired 181 Queen Street, received approval to acquire 131 Queen Street, and secured 40 Elgin Street for the Senate of Canada. These acquisitions are expected to generate savings of over $300 million for Canadians by eliminating long-term leases and enabling energy-efficient upgrades. The integration of these properties is essential in ensuring the delivery of modern, secure, and sustainable spaces for Parliament.

Sustainability and accessibility

Across all projects, PSPC is committed to sustainable building practices such as reusing materials like steel and copper, integrating low-carbon concrete, and upgrading to energy-efficient building systems. Accessibility improvements are being realized through major rehabilitation efforts such the Centre Block and Block 2, with smaller improvements to operational buildings being executed in a cost-effective manner.

Engagement with First Nations, Inuit and Métis Peoples

This year marked important milestones to advance work on a national space for First Nations, Inuit, and Métis Peoples, a dedicated space for the Anishinàbe Algonquin Nation, as well as continued progress in capacity-building and procurement with Indigenous businesses and communities.

As building custodian, proactive maintenance, timely repairs, and planned life-cycle asset replacement are essential to keeping the Parliamentary Precinct functional and responsive to parliamentary needs. In 2024 to 2025, PSPC carried out close to 15,000 maintenance activities and completed over 50 minor projects across the Parliamentary Precinct. These included repairs, system replacements, and life-cycle upgrades such as painting the Summer Pavillon to refurbishing bathrooms in the Confederation Building.

As we look ahead, our focus remains on delivering a Precinct that is secure, sustainable, and ready to serve Parliament for decades to come. I invite all Canadians to follow our progress via the PSPC website, which features Centre Block Quarterly Updates as well as the Cable Public Affairs Channel (CPAC) documentary series Inside Centre Block. For an in-person experience, come visit the construction during Doors Open Ottawa, an event held annually in June. Finally, the Parliament Hill Cam is available at all times and features live images of Parliament Hill.

Jennifer Garrett
Assistant Deputy Minister
Science and Parliamentary Infrastructure Branch

Year in review

Financial highlights

In fiscal year 2024 to 2025, PSPC's expenditures under the LTVP totaled $562.5 million across 5 core programs: Major Capital Program (MCP), Recapitalization Program, Building Components and Connectivity Program (BCC), Security Infrastructure Program and Support and Planning Program.

Major Capital Program

Advancement of the Major Capital Program represented $519 million or 92% of overall program expenditures, which includes the Centre Block rehabilitation ($332 million), Parliament Welcome Centre ($56 million), and Block 2 redevelopment ($43 million).

Recapitalization

The Recapitalization Program accounted for $2.7 million, or approximately 0.5% of total expenditures with a focus on ensuring operational continuity and safety. The replacement of the East Block Fire Alarm is an example of a project that is being executed under this program.

Building Components and Connectivity Program

The Building Components and Connectivity Program accounted for $17.5 million, representing 3% of total expenditures this fiscal year. These expenditures supported the deployment of modern communication and information technology (IT) systems across the Precinct.

Security Infrastructure Program

The Security Infrastructure Program accounted for $0.8 million (0.1%) and was focused on advancing perimeter security enhancements.

Support and Planning Program

The Support and Planning Program represented $22 million or approximately 4% of total expenditures. This program provided supplemental funding to the Parliamentary Administrations to enable them to effectively support LTVP execution. In addition, the program also supported PSPC strategic planning and program management, which provides the structure required to coordinate multi-year initiatives, manage risks, and ensure accountability—critical to the effective execution of the LTVP.

For further details, please refer to the Program financial performance section.

Guiding the future of the Parliamentary Precinct: The 2025 Long Term Vision and Plan Update

The LTVP is a multi-decade strategy to restore, modernize, and secure the Parliamentary Precinct. Last updated in 2006, the 2025 update introduces a renewed vision and strategic direction for the parliamentary campus. The update was endorsed by the Senate of Canada and is pending House of Commons and Cabinet endorsement. It reaffirms PSPC's commitment to delivering a modern, integrated, and secure parliamentary campus that is accessible to all.

A key priority of the 2025 LTVP is addressing emerging security challenges while maintaining democratic openness. This includes ongoing discussions with the City of Ottawa regarding the future of Wellington Street and its role within the campus footprint.

In the coming year, PSPC will secure final approvals from Parliament for the updated Plan. In addition, PSPC will continue engagements with the National Capital Commission (NCC) on their updated Core Area Plan and Confederation Boulevard Guidelines to ensure that the Parliamentary Precinct continues to evolve in harmony with its surroundings.

Major Capital Program

The Major Capital Program delivers transformative projects that preserve and modernize Canada's Parliamentary Precinct. Flagship initiatives include the Centre Block rehabilitation, the Parliament Welcome Centre, and the redevelopment of Block 2.

In this section

Centre Block Rehabilitation Program

A comprehensive overhaul is well underway to ensure this iconic building meets the needs of a modern parliamentary democracy. PSPC is also constructing Canada's new Parliament Welcome Centre—designed to transform and modernize parliamentary operations by providing future-ready building systems and expansion to account for growth, while housing a world-class visitor experience.

Description follows

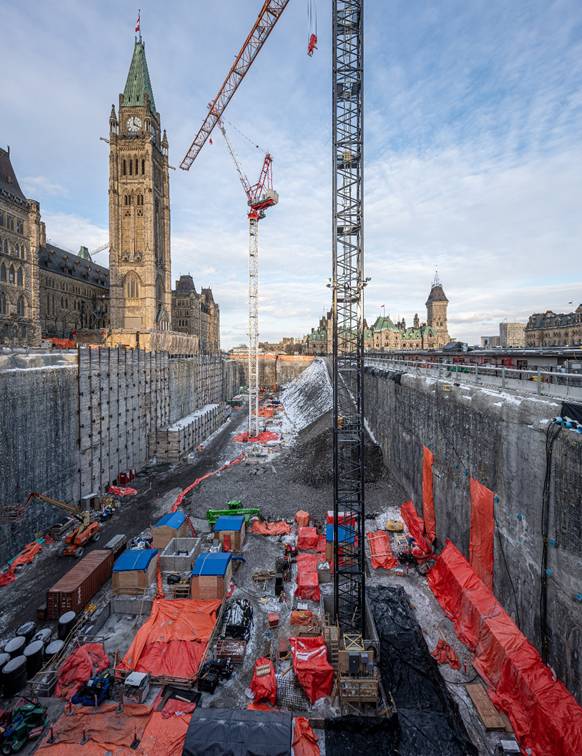

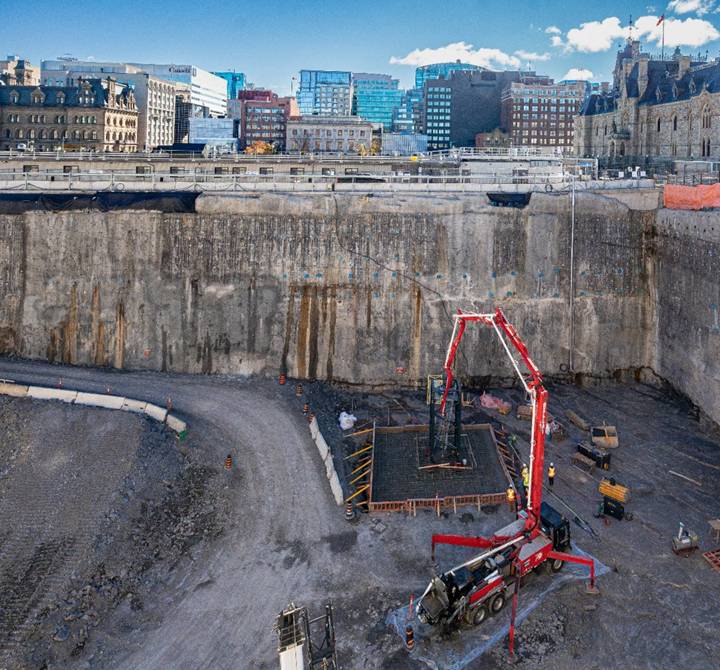

View of the Parliament Welcome Centre trench and construction site in front of Centre Block.

Design progress: Over the past year, substantial progress was made in advancing detailed design for the Centre Block, Parliament Welcome Centre, and the surrounding landscape. As a national gathering place, the new landscape design, completed in February 2025, aims to connect people with this national historic site through significant accessibility enhancements and new gardens featuring local plants and trees that reflect the character of the region. The design development phase for both the Centre Block and the Parliament Welcome Centre is on track for 100% completion by the end of 2025.

Description follows
Centre Block Forecourt design.

Description follows
Centre Block Forecourt design featuring tulip gardens.

Description follows
Landscape design behind the Centre Block.

Construction progress: The rebuild process has begun at the Parliament Welcome Centre starting with the installation of 2 of the 4 tower cranes that will support the construction of footings, walls, columns, staircases, and elevator shafts.

Description follows
Cross-section showing how the Parliament Welcome Centre will connect with the Centre Block.

Description follows

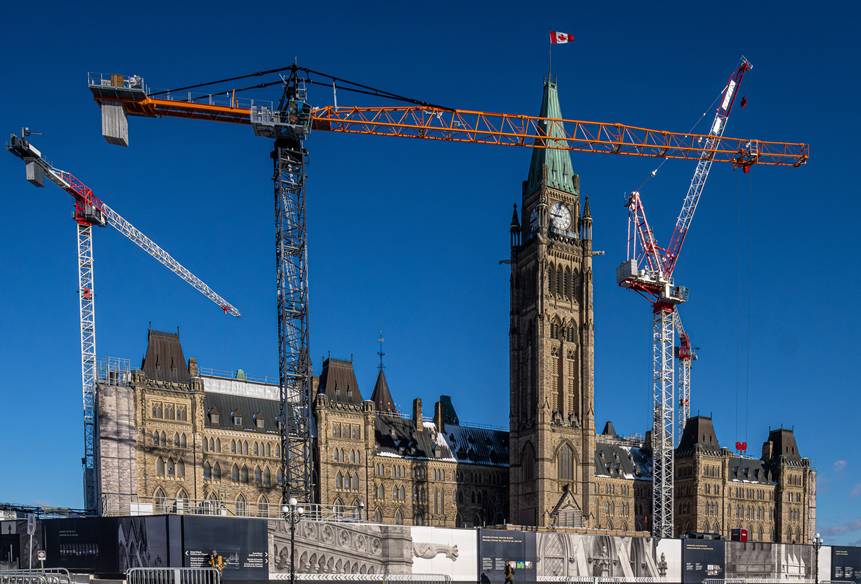

Crane installation in the Parliament Welcome Centre footprint.

Description follows
Crane installation in the Parliament Welcome Centre footprint.

Inside the Centre Block, one of the most technically complex aspects of the project is underway: stabilizing the building so that PSPC can excavate beneath. To support this work, as of March 2025, 95% of the basement support posts had been drilled and 33% of the level 1 concrete slab had been replaced. The installation of temporary bracing in the upper floors will allow for removal and replacement of existing floor slabs starting on levels 5 and 6.

Workers and machinery

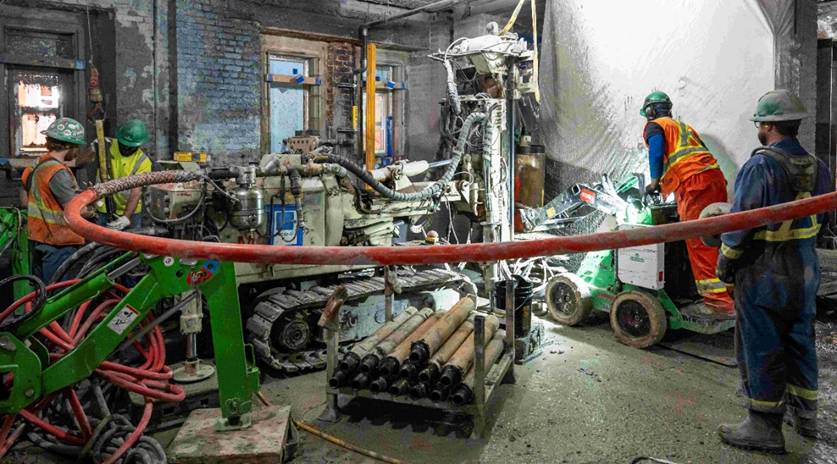

Workers drilling support posts with machinery in the Centre Block.

Externally, temporary roof enclosures are being installed to facilitate restoration of the sloped mansard roof. With the west side enclosure complete, removal of the copper roof started in spring 2025. Behind the trompe l'oeil, masonry restoration continues to progress, with approximately 20% of the overall scope completed.

Description follows

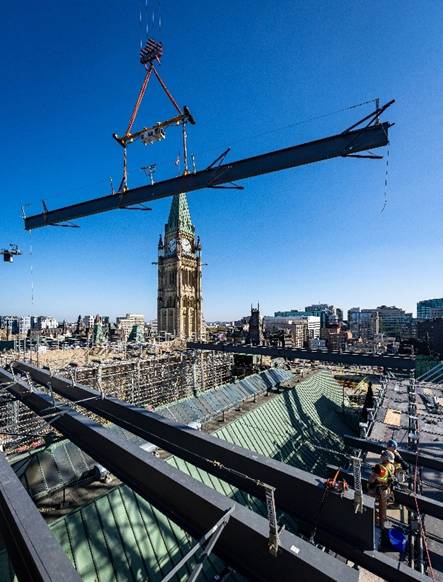

Crane raising beam at construction site for the Centre Block temporary roof enclosure.

Heritage conservation efforts continue off-site. 22 Carillion bells from the Peace Tower, all 17 Crisp murals from the House of Commons Reading Room, 8 heritage light fixtures, and 20 leaded glass panels have been restored.

Description follows

Worker welding piece of metal for heritage light fixture restoration.

To follow the progress of this historic transformation, quarterly updates are available on the PSPC website. For a behind-the-scenes look at the scale and significance of the project, watch Inside Centre Block, a documentary produced by CPAC.

Block 2 redevelopment

The Block 2 redevelopment will transform outdated heritage buildings into modern spaces to support the Senate and the House of Commons and complete the fourth wall of Canada's parliamentary square.

Design progress: A design competition was completed in May 2022, with the winning design contract awarded to Zeidler Architecture Inc. (Toronto, Canada) in association with David Chipperfield Architects (London, United Kingdom) in May 2023. Since that time, the design team has undertaken a fulsome review of parliamentary requirements to evolve the original design concept to 50% schematic design, which was completed in July 2024. 90% completion is targeted for next fiscal year.

Construction progress: The construction site was mobilized in fall 2024, enabling the start of the removal and relocation of infrastructure and targeted demolition and abatement. In the coming fiscal year, construction activities will focus on continued abatement and the stabilization of building façades to prepare for more extensive demolition.

Description follows
Birks Building with construction scaffolding for abatement marquee in support of the Block 2 Rehabilitation.

Description follows

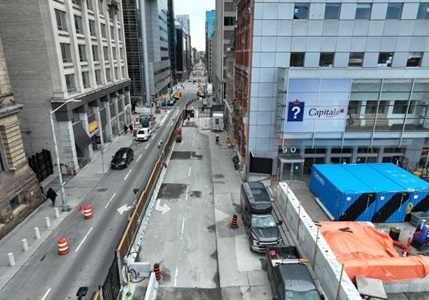

Aerial street view of installation of Block 2 hoarding along Sparks Street.

In June 2024, PSPC relocated the Terry Fox Memorial Sculpture to its permanent location on Sparks Street which is situated along the "Marathon of Hope" where Terry Fox ran in 1980. PSPC would like to thank the Fox family, the family of sculptor John Hooper, the Sparks Street Business Improvement Area, the NCC, and the City of Ottawa for their contributions in this endeavor.

Description follows
Darryl Fox with Terry Fox's sculpture during the sculpture's rededication ceremony.

Block 2 enabling projects (40 Elgin and 60 Queen)

Senate offices are being relocated to 40 Elgin Street to enable the decanting and rehabilitation of the Victoria Building. Design is complete and construction is now underway. Although the long-term strategy is to consolidate the Senate Administration at 40 Elgin Street, a portion of the Administration has been temporarily relocated to a retrofitted space at 60 Queen Street to provide the necessary space at 40 Elgin Street for Senator Offices.

National space for First Nations, Inuit and Métis Peoples and dedicated Algonquin space

Situated in the middle of Block 2 is a new national space for First Nations, Inuit and Métis Peoples and a dedicated Algonquin space. In March 2025, a Letter of Intent and a Collaboration Implementation Framework were signed by the Ministers of Crown-Indigenous Relations and Northern Affairs Canada (CIRNAC) and PSPC, Assembly of First Nations, Inuit Tapiriit Kanatami, and the Métis National Council. These agreements reaffirm a shared commitment to redevelop 100 Wellington Street and 119 Sparks Street. A similar agreement between the Grand Chief, Chiefs, and Councils from the Anishinàbe Algonquin Nation and the Minister of CIRNAC was also signed in June 2024 to establish a dedicated Algonquin space. With both agreements now in place, efforts are focused on defining the functional program and initiating preliminary design to inform project costs.

Description follows
Exterior view of 100 Wellington Street and 119 Sparks Street, which will house the future national space for First Nations, Inuit and Métis Peoples.

Parliamentary Campus Tunnels project

The Tunnels project is a key Parliamentary Campus initiative that will enhance security and pedestrian connections for key buildings on both sides of Wellington Street, including approximately 50% of Parliamentarians that will be accommodated south of Wellington Street by the mid-2030's timeframe.

The project received formal endorsement from the Subcommittee on the Long Term Vision and Plan and the Working Group on the LTVP and Centre Block rehabilitation in February 2024. The project is now focused on the procurement process for the design, with contract award anticipated in spring 2026.

Additional parliamentary offices (Wellington and Valour Buildings)

To accommodate new Members of Parliament (MP) under the Fair Representation Act, 15 new parliamentary offices are being added to the Wellington and Valour Buildings. With design complete, construction efforts are underway with completion targeted for next fiscal year.

Recapitalization Program

The Recapitalization Program preserves operational buildings and grounds on Parliament Hill that have not yet undergone full rehabilitation. These projects mitigate deterioration, address urgent health and safety issues, and reduce future rehabilitation costs by leveraging early interventions.

Repairs have been initiated to the Confederation, Justice and East Block buildings, allowing them to remain operational until their comprehensive rehabilitations commence. For the Confederation Building, work will focus on replacing the central wing flat roof, fan coils, chilled water lines, and sanitary plumbing, as well as repairing masonry gables. This year, planning advanced through the design phase, with preparatory work expected over the next 2 years. In the Justice Building, the design phase was advanced for the replacement of the Perimeter Heating & Risers and the replacement of the building's flat roof. Finally, in East Block, the Flat Roof Replacement and Fire Alarm Replacement projects progressed through the design phase in fiscal year 2024 to 2025, positioning them for implementation in 2025 and 2026.

PSPC also initiated restoration of the Queen's Gates, showcasing Canadian heritage expertise. This year, the gates were disassembled, cleaned, and restored, with reinstallation planned for next fiscal year.

Description follows
Panorama of the Queen's Gates prior to removal.

Description follows
Worker fixing a piece of the gate for the rehabilitation of the Queen's Gates.

Description follows

Two workers fixing ornate metal gate for the rehabilitation of the Queen's Gates.

Building Components and Connectivity Program

The Building Components and Connectivity Program delivers IT systems to strengthen digital infrastructure and meet evolving operational needs. In 2024 to 2025, PSPC completed the modernization of Parliament Community Access Television (CATV), transitioning to a digital platform that improves reliability and performance. The Data Centre Risk Mitigation project was also finalized, establishing a dedicated disaster recovery site to protect critical operations and ensure business continuity. Core network upgrades were completed under the Network Infrastructure Transformation project, improving speed, reliability, and security to support virtual operations and smart building integration.

A new multimedia strategy is being implemented to enable remote broadcasting and interpretation services across the campus. PSPC launched the Multimedia Enabling project and began validating technical feasibility through a proof of concept. Results from this phase will inform the Multimedia Core Facility project, scheduled for design after 2027.

To strengthen IT security and business continuity, PSPC initiated the Core Data Centre Co-location project. In 2024 to 2025, PSPC secured approval to relocate data centre operations to a new off-site facility and launched a proof of concept to validate functionality. Implementation is scheduled to begin in the next fiscal year.

Security Program

PSPC is strengthening perimeter security by replacing hydraulic bollards along Parliament's grounds. In 2024 to 2025, PSPC began replacing aging bollards as part of routine life-cycle maintenance. Completion is anticipated in the next fiscal year, with measures in place to minimize operational disruptions during installation.

Support and Planning Program

In this section

The Support and Planning Program supports the oversight, planning, and governance required to deliver the LTVP. It acts as the critical link between short-term priorities and long-term objectives, ensuring alignment across precinct-wide initiatives, pre-planning for future projects, and monitoring overall implementation. The program also strengthens transparency, and supports stakeholder engagement.

This program also provided supplemental funding to the parliamentary administrations to enable them to effectively support LTVP execution.

Engagement with First Nations, Inuit and Métis Peoples

PSPC continued to engage with the Anishinàbe Algonquin Nation and National Indigenous Organizations on initiatives of shared interest, including planning for a national space for First Nations, Inuit, and Métis Peoples and a dedicated Algonquin space. In 2024 to 2025, PSPC also achieved the following milestones:

Description follows

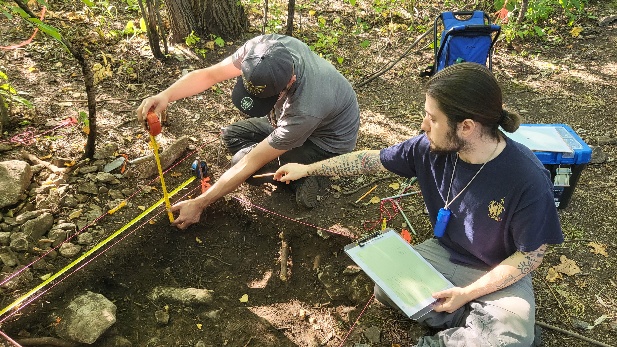

2 field school participants around a dig site, engaging in archaeological activities.
Credit: Anishinàbe Odjìbikan Field School

Advancing sustainability

PSPC continued to advance environmental sustainability and climate resilience across the Parliamentary Precinct. In 2024 to 2025, PSPC achieved the following:

Enhancing accessibility

Significant accessibility improvements are being realized through major rehabilitation efforts such the Centre Block and Block 2, with smaller improvements to operational buildings that can be executed in a cost-effective manner. To support this effort, PSPC conducts Building Accessibility Audits. During this reporting period, 6 additional buildings were completed, bringing the total to 29 out of 34. Based on these reviews, 29 immediate accessibility improvements were completed, with another 16 underway. These include adding high-contrast signs, upgrading grab bars, and installing foldable change tables to make spaces easier and safer for everyone to use.

Engagement and transparency

PSPC remains committed to transparency and accountability in modernizing Canada's Parliamentary Precinct, providing regular updates to parliamentarians and Canadians.

Parliamentary engagement

The execution of the LTVP is complex, with split accountabilities: Parliament defines operational requirements, while PSPC is accountable for funding and program execution. The success of the LTVP depends upon timely and coordinated decision making supported by an integrated governance model between PSPC and the Parliamentary Administrations, including Senate and House of Commons parliamentary committees.

International engagement

PSPC continues to participate in the International Network of Parliamentary Properties (INPP). These engagements continue to provide Canada with valuable opportunities to lead and learn in the fields of parliamentary modernization and heritage preservation.

Public engagement

In June 2024, PSPC welcomed over 2,800 visitors to the Centre Block construction site to witness rehabilitation progress firsthand, engage directly with experts, and explore virtual walkthroughs of designs for the future Parliament Welcome Centre. PSPC also supports the CPAC documentary series "Inside Centre Block", as well as provides annual media tours of the Centre Block construction site. This year, 30 accredited media outlets participated.

Description follows
Dominion Sculptor John-Philippe Smith engages with a visitor at the Decorative Arts display during Doors Open Ottawa.

Description follows
PSPC Director General explains Centre Block rendering to a visitor during Doors Open Ottawa.

Description follows
View of the Centre Block in March 2025.

Program financial performance

In this section

Fiscal year financial highlights

Significant progress was made in 2024 to 2025 to advance the LTVP, as well as the planning of future projects.

Below are the Long Term Vision and Plan expenditures in fiscal year 2024 to 2025 (in millions of dollars).

Table 1: Long Term Vision and Plan expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Planned expenditures Actual expenditures Percentage spent
544.7 562.5 103.3%
Table 2: Total Long Term Vision and Plan expenditures by program in fiscal year 2024 to 2025 (in millions of dollars)
Program Expenditures Percentage
Major Capital Program 519.3 92.3%
Recapitalization Program 2.7 0.5%
Building Components and Connectivity Program 17.5 3.1%
Security Infrastructure Program 0.8 0.1%
Support and Planning Program 22.2 3.9%
Total LTVP expenditures 562.5 100%
Table 3: Total Long Term Vision and Plan planned expenditures by program in fiscal year 2024 to 2025 (in millions of dollars)
Program Expenditures Percentage
Major Capital Program 501.2 92.0%
Recapitalization Program 2.8 0.5%
Building Components and Connectivity Program 16.8 3.1%
Security Infrastructure Program 0.9 0.2%
Support and Planning Program 23.1 4.2%
Total LTVP expenditures 544.7 100%

Major Capital Program

Table 4: Long Term Vision and Plan Major Capital Program annual planned expenditures and expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Fiscal year Annual planned expenditures table 4 note 1 Annual expenditures
Prior years 46.0 44.1
2002 to 2003 29.1 26.5
2003 to 2004 23.4 38.8
2004 to 2005 40.6 44.4
2005 to 2006 64.5 44.2
2006 to 2007 65.4 67.5
2007 to 2008 58.9 58.2
2008 to 2009 62.1 66.3
2009 to 2010 121.3 120.7
2010 to 2011 109.6 112.9
2011 to 2012 126.2 125.5
2012 to 2013 202.8 180.4
2013 to 2014 246.6 246.8
2014 to 2015 301.4 306.9
2015 to 2016 346.6 328.0
2016 to 2017 289.7 293.1
2017 to 2018 342.8 336.9
2018 to 2019 349.0 346.4
2019 to 2020 321.7 300.4
2020 to 2021 301.2 290.0
2021 to 2022 314.1 290.7
2022 to 2023 257.8 266.7
2023 to 2024 464.7 459.1
2024 to 2025 501.2 519.3
2025 to 2026 607.8 Not applicable (n/a)
2026 to 2027 592.4 n/a

Table 4 note

Table 4 note 1

Prior to 2020 to 2021, the budget is displayed instead of planned expenditures.

Return to table 4 note 1 referrer

Recapitalization Program

Table 5: Long Term Vision and Plan Recapitalization Program annual planned expenditures and expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Fiscal year Annual planned expenditurestable 5 note 1 Annual expenditures
Prior years 11.0 11.0
2002 to 2003 14.4 14.4
2003 to 2004 25.6 25.6
2004 to 2005 6.8 6.8
2005 to 2006 3.7 3.7
2006 to 2007 3.2 3.2
2007 to 2008 5.4 5.4
2008 to 2009 3.5 3.5
2009 to 2010 2.4 2.4
2010 to 2011 7.5 7.3
2011 to 2012 14.5 13.5
2012 to 2013 15.4 15.9
2013 to 2014 15.2 15.9
2014 to 2015 22.9 18.8
2015 to 2016 23.8 23.6
2016 to 2017 31.1 21.5
2017 to 2018 24.7 23.4
2018 to 2019 15.7 14.8
2019 to 2020 35.2 14.1
2020 to 2021 29.6 31.0
2021 to 2022 40.0 37.9
2022 to 2023 17.3 17.4
2023 to 2024 3.4 3.5
2024 to 2025 2.8 2.7
2025 to 2026 4.1 n/a
2026 to 2027 13.6 n/a

Table 5 note

Table 5 note 1

Prior to 2020 to 2021, the budget is displayed instead of planned expenditures.

Return to table 5 note 1 referrer

Building Components and Connectivity Program

Table 6: Long Term Vision and Plan Building Components and Connectivity Program annual planned expenditures and expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Fiscal year Annual planned expenditurestable 6 note 1 Annual expenditures
Prior years 6.3 6.3
2002 to 2003 5.2 5.2
2003 to 2004 7.5 7.5
2004 to 2005 7.0 7.0
2005 to 2006 7.9 7.9
2006 to 2007 12.0 12.0
2007 to 2008 3.5 3.5
2008 to 2009 2.2 2.2
2009 to 2010 1.0 1.0
2010 to 2011 5.7 5.5
2011 to 2012 3.4 3.4
2012 to 2013 5.2 5.0
2013 to 2014 15.3 14.9
2014 to 2015 21.2 19.4
2015 to 2016 19.5 23.1
2016 to 2017 17.6 15.7
2017 to 2018 17.6 14.7
2018 to 2019 32.4 31.2
2019 to 2020 18.0 17.8
2020 to 2021 17.2 16.6
2021 to 2022 19.9 20.3
2022 to 2023 23.4 25.8
2023 to 2024 16.8 15.2
2024 to 2025 16.8 17.5
2025 to 2026 26.3 n/a
2026 to 2027 65.3 n/a

Table 6 note

Table 6 note 1

Prior to 2020 to 2021, the budget is displayed instead of planned expenditures.

Return to table 6 note 1 referrer

Security Infrastructure Program

Table 7: Long Term Vision and Plan Security Infrastructure Program annual planned expenditures and expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Fiscal year Annual planned expenditurestable 7 note 1 Annual expenditures
2015 to 2016 0.0 0.0
2016 to 2017 22.5 12.6
2017 to 2018 91.4 91.4
2018 to 2019 52.8 52.8
2019 to 2020 0.0 0.0
2020 to 2021 0.0 0.0
2021 to 2022 0.2 0.3
2022 to 2023 0.4 0.2
2023 to 2024 0.2 0.3
2024 to 2025 0.9 0.8
2025 to 2026 3.0 n/a
2026 to 2027 0.9 n/a

Table 7 note

Table 7 note 1

Prior to 2020 to 2021, the budget is displayed instead of planned expenditures.

Return to table 7 note 1 referrer

Support and Planning Program

Table 8: Long Term Vision and Plan Support and Planning Program annual planned expenditures and expenditures in fiscal year 2024 to 2025 (in millions of dollars)
Fiscal year Annual planned expenditurestable 8 note 1 table 8 note 2 Annual expenditures
Prior years 5.8 5.8
2002 to 2003 1.6 1.6
2003 to 2004 2.4 2.4
2004 to 2005 2.0 2.0
2005 to 2006 2.6 2.6
2006 to 2007 1.1 1.1
2007 to 2008 0.4 0.4
2008 to 2009 1.5 1.5
2009 to 2010 1.8 1.8
2010 to 2011 3.7 3.7
2011 to 2012 4.0 3.9
2012 to 2013 4.4 3.9
2013 to 2014 5.5 6.1
2014 to 2015 12.4 10.7
2015 to 2016 18.1 13.1
2016 to 2017 21.1 21.4
2017 to 2018 9.8 9.8
2018 to 2019 14.9 13.2
2019 to 2020 21.5 21.5
2020 to 2021 14.2 17.3
2021 to 2022 15.0 19.7
2022 to 2023 22.1 21.2
2023 to 2024 20.9 20.0
2024 to 2025 23.1 22.2
2025 to 2026 23.6 n/a
2026 to 2027 0.0 n/a

Table 8 notes

Table 8 note 1

Prior to 2020 to 2021, the budget is displayed instead of planned expenditures.

Return to table 8 note 1 referrer

Table 8 note 2

Support and planning program planned expenditures will be updated based on upcoming funding decisions.

Return to table 8 note 2 referrer

Program information summary

In this section

Table 9: Project expenditures and delivery timeline (in millions of dollars)
Program Program budgettable 9 note 1 Expenditure authority Planned expenditures 2024 to 2025table 9 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 9 note 3 Planned expenditures 2026 to 2027 and future yearstable 9 note 3
Total Major Capital Program 11.1 billion to 11.6 billion 8,277.5 501.2 4,366.1 519.3 4,885.5 607.8 4,809.0
Total Recapitalization Program 406.0 382.9 2.8 367.7 2.7 370.4 4.1 29.9
Total Building Components and Connectivity Program 434.9 352.2 16.8 281.3 17.5 298.8 26.3 99.6
Total Security and Infrastructure Program 162.2 162.2 0.9 157.5 0.8 158.3 3.0 0.9
Total Support and Planning Program 250.7 250.7 23.1 204.6 22.2 226.8 23.6 0.0
Grand total LTVP 12.4 billion to 12.9 billion 9,425.4 544.7 5,377.3 562.5 5,939.8 664.8 4,939.5

Table 9 notes

Table 9 note 1

Program budget for leases have been adjusted to reflect escalation.

Return to table 9 note 1 referrer

Table 9 note 2

Period 8 forecasts are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 9 note 2 referrer

Table 9 note 3

Forecasts do not exceed project approval values.

Return to table 9 note 3 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Major Capital Program

Table 10: Major Capital Program expenditures and delivery timeline (in millions of dollars)
Project Project budgettable 10 note 1 Expenditure authority Planned expenditures 2024 to 2025table 10 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 10 note 3 Planned expenditures 2026 to 2027 and future yearstable 10 note 3 Substantial completion date
Centre Block rehabilitationtable 10 note 4 4.5 billion to 5 billion 3,790.2 316.5 680.1 331.6 1,011.7 377.9 1,335.2 2030 to 2031
Parliament Welcome Centretable 10 note 4 Cost included in Centre Block rehabilitation Cost included in Centre Block rehabilitation 58.1 184.3 55.7 240.0 102.8 722.6 2030 to 2031
Centre Block Program: Enablings/early workstable 10 note 5 table 10 note 6 569.6 569.6 0.0 487.2 0.0 487.2 0.0 0.0 2024
100 Sparks and 30 Metcalfe redevelopment 308.0 56.1 1.5 30.6 1.3 31.9 0.0 276.0 2029
Block 2 redevelopment 1,372.5 487.1 40.0 38.6 42.8 81.4 65.2 1,225.9 To be determined
Trompe L'Oeil scaffold coverings 4.5 4.5 0.4 1.5 0.7 2.2 0.4 1.9 2028
40 Elgin Senate fit-up 241.3 162.8 60.8 7.9 61.7 69.6 21.5 150.2 2029
Valour Building: House of Commons parliamentary office units 28.4 28.4 2.2 1.0 3.3 4.3 13.6 10.5 2026
Wellington Building: House of Commons parliamentary office units 17.3 17.3 2.4 0.8 2.9 3.7 7.3 3.8 2025
181 Queen Street purchase 131.6 131.6 0.0 123.8 0.0 123.8 0.0 0.0 2024
Relocation of high voltage duct bank 13.0 13.0 0.9 0.0 0.1 0.1 10.9 2.0 2027
Leased and lease fit-up 737.4 737.4 12.4 622.8 12.9 635.7 5.2 96.4 n/a
Other MCP (active) 1,039.0 127.5 6.0 35.3 6.3 41.7 3.0 984.5 n/a
Completed MCP 2,152.1 2,152.1 0.0 2,152.1 0.0 2,152.1 0.0 0.0 n/a
Total MCP 11.1 billion to 11.6 billion 8,277.5 501.2 4,366.1 519.3 4,885.5 607.8 4,809.0 n/a

Table 10 notes

Table 10 note 1

Project budget for leases have been adjusted to reflect escalation.

Return to table 10 note 1 referrer

Table 10 note 2

Period 8 forecasts are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 10 note 2 referrer

Table 10 note 3

Forecasts do not exceed project approval values.

Return to table 10 note 3 referrer

Table 10 note 4

Authorities and expenditures for the Centre Block and Parliament Welcome Centre, and enabling and early works, have been updated from previous years to reflect additional Treasury Board authorities and to align with the 2021 public baseline of the Centre Block Rehabilitation Program.

Return to table 10 note 4 referrer

Table 10 note 5

Includes early works required to establish the program as well as projects carried out that serve broader LTVP objectives (for example, relocation of Books of Remembrance and Monuments; relocation of the National Press Hot Room and Library of Parliament Refit at 125 Sparks St; and the construction of the Parliament Hill Temporary Loading Dock).

Return to table 10 note 5 referrer

Table 10 note 6

Most project elements targeted for completion in 2022 to 2023. Remaining Expenditure Authority to be reallocated within the program.

Return to table 10 note 6 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Recapitalization Program

Table 11: Recapitalization Program expenditures and delivery timeline (in millions of dollars)
Project Project budgettable 11 note 1 Expenditure authority Planned expenditures 2024 to 2025table 11 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 11 note 3 Planned expenditures 2026 to 2027 and future yearstable 11 note 3 Substantial completion date
East Block 1867 wing exterior rehabilitationtable 11 note 4 95.8 95.8 0.0 95.8 0.0 95.8 0.0 0.0 2022
Lighting implementation: West Block 9.2 9.2 0.2 9.0 0.2 9.2 0.0 0.0 2023
Confederation interior lifecycle repair and replacement 18.8 2.4 0.1 0.0 0.1 0.1 0.9 17.8 2029
Confederation exterior lifecycle repair and replacement 8.0 1.3 0.1 0.0 0.1 0.1 0.5 7.4 2028
100 Wellington: Interim heating 1.0 1.0 0.0 1.0 0.0 1.0 0.0 0.0 2024
Fire alarm system: East Block 6.4 6.4 0.5 0.0 0.5 0.5 1.7 4.2 2027
Queen's Gate rehabilitation 2.6 2.6 1.1 0.1 1.1 1.2 0.8 0.6 2025
Other recap (active) 3.8 3.8 0.6 1.3 0.7 2.0 0.2 0.0 n/a
Completed recap 260.5 260.5 0.2 260.5 0.0 260.5 0.0 0.0 n/a
Total recapitalization 406.0 382.9 2.8 367.7 2.7 370.4 4.1 29.9 n/a

Table 11 notes

Table 11 note 1

Project budget for leases have been adjusted to reflect escalation.

Return to table 11 note 1 referrer

Table 11 note 2

Period 8 forecasts are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 11 note 2 referrer

Table 11 note 3

Forecasts do not exceed project approval values.

Return to table 11 note 3 referrer

Table 11 note 4

Project completed. The forecasted expenditures are associated with project close-out activities.

Return to table 11 note 4 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Building Components and Connectivity Program

Table 12: Building Components and Connectivity Program expenditures and delivery timeline (in millions of dollars)
Project Project budgettable 12 note 1 Expenditure authority Planned expenditures 2024 to 2025table 12 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 12 note 3 Planned expenditures 2026 to 2027 and future yearstable 12 note 3 Substantial completion date
Modernization of the Parliament CATV 14.8 14.8 0.9 13.8 1.0 14.8 0.0 0.0 2024
IT infrastructure base building upgrades 15.2 15.2 0.9 13.3 0.6 13.9 0.0 0.4 2027
Datacentre disaster recovery projects 37.0 37.0 1.0 35.7 1.0 36.7 0.1 0.2 2027
Video surveillance and security systems 7.7 7.7 0.5 7.0 0.6 7.6 0.1 0.0 2025
Network infrastructure transformation 22.5 9.5 3.9 3.2 3.7 6.9 4.0 11.6 2028
Centre Block multimedia enabling 21.1 21.1 4.9 0.0 5.4 5.4 4.4 11.3 2027
Core data centre colocation 96.4 26.7 0.0 0.0 0.7 0.7 13.3 74.4 2030
Other BCC (active) 34.7 34.7 4.6 22.8 4.6 27.4 4.3 1.6 n/a
Completed BCC 185.5 185.5 0.0 185.5 0.0 185.5 0.0 0.0 n/a
Total BCC 434.9 352.2 16.8 281.3 17.5 298.8 26.3 99.6 n/a

Table 12 notes

Table 12 note 1

Project budget for leases have been adjusted to reflect escalation.

Return to table 12 note 1 referrer

Table 12 note 2

Period 8 forecasts are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 12 note 2 referrer

Table 12 note 3

Forecasts do not exceed project approval values.

Return to table 12 note 3 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Security Infrastructure Program

Table 13: Security Infrastructure Program expenditures and delivery timeline (in millions of dollars)
Project Project budgettable 13 note 1 Expenditure authority Planned expenditures 2024 to 2025table 13 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 13 note 3 Planned expenditures 2026 to 2027 and future yearstable 13 note 3 Substantial completion date
Perimeter security enhancement 4.8 4.8 0.9 0.1 0.8 0.9 3.0 0.9 2025
Completed security 157.4 157.4 0.0 157.4 0.0 157.4 0.0 0.0 n/a
Total Security Infrastructure Program 162.2 162.2 0.9 157.5 0.8 158.3 3.0 0.9 n/a

Table 13 notes

Table 13 note 1

Project budget for leases have been adjusted to reflect escalation.

Return to table 13 note 1 referrer

Table 13 note 2

Period 8 forecasts are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 13 note 2 referrer

Table 13 note 3

Forecasts do not exceed project approval values.

Return to table 13 note 3 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Support and Planning Program

Table 14: Support and Planning Program expenditures and delivery timeline (in millions of dollars)
Project Project budgettable 14 note 1 Expenditure authority Planned expenditures 2024 to 2025table 14 note 2 Previous years expenditures Expenditures 2024 to 2025 Cumulative expenditures up to 2024 to 2025 Planned expenditures 2025 to 2026table 14 note 3 Planned expenditures 2026 to 2027 and future yearstable 14 note 3 Substantial completion date
Campus planning 11.7 11.7 0.6 10.8 0.5 11.3 0.1 0.0 n/a
Planning program support 138.5 138.5 22.5 93.3 21.7 115.0 23.5 0.0 n/a
Completed planning 100.5 100.5 0.0 100.5 0.0 100.5 0.0 0.0 n/a
Planning total 250.7 250.7 23.1 204.6 22.2 226.8 23.6 0.0 n/a

Table 14 notes

Table 14 note 1

Project budget for leases have been adjusted to reflect escalation.

Return to table 14 note 1 referrer

Table 14 note 2

Period 8 forecasts a are in alignment with the annual performance measurement by the Treasury Board in the management accountability framework.

Return to table 14 note 2 referrer

Table 14 note 3

Forecasts do not exceed project approval values.

Return to table 14 note 3 referrer

Remarks

Numbers may not add up due to rounding.

Planned expenditures may require project approval and/or expenditure authority amendments.

Lease cost breakdown

Table 15: Long Term Vision and Plan lease cost breakdown (in millions of dollars)
LTVP leases Total lease cost forecastedtable 15 note 1 Previous years expenditures Forecasted expenditures 2024 to 2025 Actual expenditures in 2024 to 2025 Total expenditures to end of fiscal year 2024 to 2025
119 Queen Street 3.6 3.6 0.0 0.0 3.6
131 Queen Street 206.5 206.5 0.0 0.0 206.5
181 Queen Street 116.9 116.9 0.0 0.0 116.9
155 Queen Street (10th Floor) 8.4 8.4 0.0 0.0 8.4
155 Queen Street (6th Floor) 0.2 0.2 0.0 0.0 0.2
2074-2086 Walkley Road, trade shops 6.3 6.3 0.0 0.0 6.3
768 Belfast Road, House of Commons 1.4 1.4 0.0 0.0 1.4
2455 Don Reid Drive, E-Printing 9.3 9.3 0.0 0.0 9.3
1 Wellington Street, Rideau committee rooms 23.0 9.8 0.4 0.4 10.1
C.D. Howe Building 26.2 26.2 0.0 0.0 26.2
Clarica / Sun Life Building 54.0 54.0 0.0 0.0 54.0
Interim Room 200, Government of Canada Conference Centre 8.5 8.5 0.0 0.0 8.5
Parks Canada 0.8 0.8 0.0 0.0 0.8
40 Elgin St. Chambers buildingtable 15 note 2 6.3 5.7 0.6 0.6 6.3
150 Slater Street 19.2 9.2 1.3 1.4 10.6
40 Elgin St., floors 8 and 12table 15 note 2 16.0 12.4 3.6 3.6 16.0
40 Elgin St., floors 9, 10 and 11table 15 note 2 10.6 8.9 1.7 1.7 10.6
40 Elgin St., land and buildingstable 15 note 2 81.0 0.0 0.3 0.3 0.3
Grand total LTVP 598.3 488.2 7.9 7.9 496.1

Table 15 notes

Table 15 note 1

Total lease cost forecasted includes the rent and escalation amounts for duration of the lease.

Return to table 15 note 1 referrer

Table 15 note 2

40 Elgin lease interest was purchased in 2024, and the new agreement includes a land lease with the NCC.

Return to table 15 note 2 referrer

Page details

2025-12-23
