July 1 to September 30, 2021: Quarterly progress report on the Centre Block project

We are restoring and modernizing the Centre Block. We are also designing and building the Parliament Welcome Centre. It is the largest and most complex heritage rehabilitation ever seen in Canada. We estimate the cost to be between $4.5 billion and $5 billion. The targeted completion date is between 2030 and 2031.

On this page

Project health

The following graph provides an overview of the project health based on approved cost, scope and schedule, each ranging from 0 (low impact of affecting the project) to 10 (high impact of affecting the project).

A chart representing project health. See long description below.
Text version for project health graph

Project health is represented by 3 elements: scope, cost and schedule. Each element’s status ranges from 0 to 10, where:

  • 0 to 4 represents the project progressing in line with the planned approved cost, scope and schedule
  • 5 to 8 represents the project progressing but experiencing challenges that may impact the approved cost, scope and schedule
  • 9 to 10 represents the project progressing but experiencing challenges that have a high likelihood of impacting the approved cost, scope and schedule

Current status:

  • Overall, the project is progressing in line with the planned approved cost, scope and schedule, with a rating of 3
  • Scope is coming up against challenges that may impact the approved scope, with a rating of 6
  • Cost is in line with the planned approved cost, with a rating of 2
  • Schedule is in line with the planned approved schedule, with a rating of 2

Construction progress

Current construction activities for the Centre Block project.

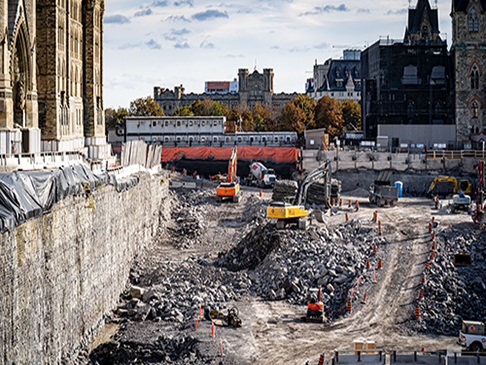

Excavation of the Parliament Welcome Centre

In spring 2020, excavation of the new Parliament Welcome Centre began. To date, about 20,000 truckloads of bedrock have been removed.

How we are excavating to build the Parliament Welcome Centre

Status: On track

Completion: About 50% complete

Demolition and abatement

Demolition and abatement activities at the Centre Block are well underway. These activities only begin once heritage features are either carefully removed or protected in place. To date, about 6.4 million kilograms (14 million pounds) of hazardous materials have been removed.

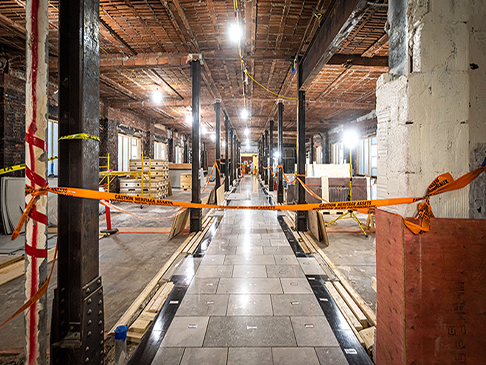

Preparing the interior of the building

Status: On track

Completion: About 55% complete

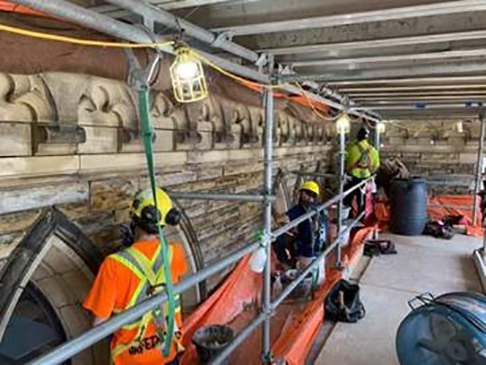

Masonry conservation

We are restoring and repairing the masonry exterior of the Centre Block and have already started on the north façade.

Preparing the exterior of the building

Status: On track

Overall completion: 3% complete

North wall completion: 15% complete

Latest progress on the Centre Block project

Cost update

Spending to date on the Centre Block project is $290 million.

The overall budget was established based on a cost report. The report was provided by an independent consultant who validated the method we used to establish cost for the construction.

Dollars spent against dollars budgeted (in billions of dollars)

A bar chart showing dollars spent against dollars budgeted. See data table below.

Financial data as of September 15, 2021.

Text version of Dollars spent against dollars budgeted graph
Spent against budget
  Spent to date Budget
Centre Block and
Parliament Welcome Centre
$290,000,000 $4,500,000,000 to $5,000,000,000

Key milestones

The timeline below illustrates the major milestones we are working on this year.

A timeline from June 2021 to 2031, with major milestones marked along the way. See long description below.
Text version of key milestones

June 2021

  • Approve cost, scope and schedule

2022

  • Remove carillon bells
  • Finalize schematic design
  • Install the “trompe l’oeil” decorative tarps
  • Begin removing the floor on level 1
  • Obtain federal land use approval
  • Start excavating the courtyard and basement
  • Conserve heritage assets
  • Start masonry work on the east and west façades
  • Complete the main excavation for the Parliament Welcome Centre

2023

  • Drill to install geothermal piping
  • Complete the demolition and abatement
  • Start building the main concrete structure for the Parliament Welcome Centre

2030 to 2031

  • Complete main construction

Project spotlight

Each quarter, we highlight an element of work being done on the Centre Block or Parliament Welcome Centre.

Modernizing the Senate and House of Commons Chambers

The beautiful heritage Chambers of the Centre Block are the place where the ideas of our country are debated and laws are passed. Modernizing will be done with great care and attention to detail while still preserving the traditional look and feel of the Chambers. The modernization will include accessibility upgrades. It will also include upgrades to building infrastructure such as broadcasting, lighting, acoustics and multimedia systems. These upgrades will support modern parliamentary operations.

How we are restoring and modernizing the Parliament buildings

View enlarged image of a computer drawing of the House of Commons Chamber design.
View enlarged image of a computer drawing of the Senate Chamber design.

Page details

Date modified:
