January 1 to March 30, 2022: Quarterly progress report on the Centre Block project

We are restoring and modernizing the Centre Block. We are also designing and building the Parliament Welcome Centre. It is the largest and most complex heritage rehabilitation ever seen in Canada. We estimate the cost to be between $4.5 billion and $5 billion. The targeted completion date is between 2030 and 2031.

On this page

Project health

The following graph provides an overview of the project health based on approved cost, scope and schedule, each ranging from 0 (low impact of affecting the project) to 10 (high impact of affecting the project).

A chart representing project health. See long description below.
Text version for project health graph

Project health is represented by 3 elements: scope, cost and schedule. Each element’s status ranges from 0 to 10, where:

  • 0 to 4 represents the project progressing in line with the planned approved cost, scope and schedule
  • 5 to 8 represents the project progressing but experiencing challenges that may impact the approved cost, scope and schedule
  • 9 to 10 represents the project progressing but experiencing challenges that have a high likelihood of impacting the approved cost, scope and schedule

Current status:

  • Overall, the project is progressing in line with the planned approved cost, scope and schedule with a rating of 2
  • Scope is in line with the planned approved scope with a rating of 2
  • Cost is in line with the planned approved cost at rating of 1
  • Schedule is in line with the planned approved schedule with a rating of 2

Construction progress

Current construction activities for the Centre Block project.

Excavation of the Parliament Welcome Centre

In spring 2020, excavation of the new Parliament Welcome Centre began. To date, about 27,000 truckloads of bedrock have been removed.

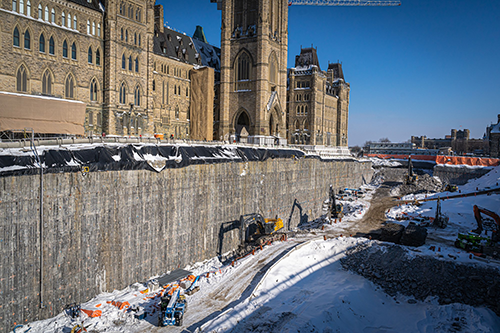

How we are excavating to build the Parliament Welcome Centre

Status: On track

Completion: 65% complete

Demolition and abatement

Demolition and abatement activities at the Centre Block are well underway. Demolition and abatement activities only begin once heritage features are either carefully removed or protected in place. To date, about 7 million kilograms (16 million pounds) of hazardous materials have been removed.

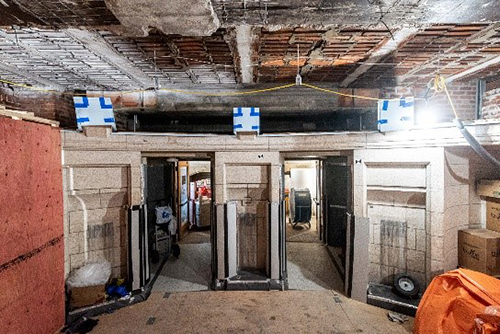

Preparing the interior of the building

Status: On track

Completion: 65% complete

Masonry conservation

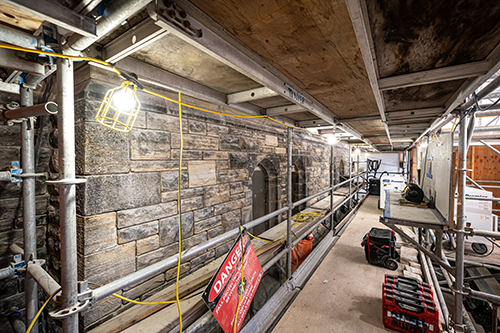

We are restoring and repairing the masonry exterior of the Centre Block and have already started on the north façade.

Preparing the exterior of the building

Status: On track

Overall completion: 5% complete

North wall completion: 25% complete

Latest progress on the Centre Block project

Cost update

Spending to date on the Centre Block project is $360 million.

The overall budget was established based on a cost report. The report was provided by an independent consultant who validated the method we used to establish cost for the construction.

Dollars spent against dollars budgeted (in billions of dollars)

A bar chart showing dollars spent against dollars budgeted. See data table below.

Financial data as of March 15, 2022.

Text version of Dollars spent against dollars budgeted graph
Spent against budget
  Spent to date Budget
Centre Block and
Parliament Welcome Centre
$360,000,000 $4,500,000,000 to $5,000,000,000

Key milestones

The timeline below illustrates the major milestones we are working on this year. The next milestone is the removal of the carillon bells.

A timeline from June 2021 to 2031, with major milestones marked along the way. See long description below.
Text version of key milestones

June 2021

  • Approve cost, scope and schedule

2022

  • Remove carillon bells
  • Finalize schematic design
  • Install the “trompe l’oeil” decorative tarps
  • Begin removing the floor on level 1
  • Obtain federal land use approval
  • Start excavating the courtyard and basement
  • Conserve heritage assets
  • Start masonry work on the east and west façades
  • Complete the main excavation for the Parliament Welcome Centre

2023

  • Drill to install geothermal piping
  • Complete the demolition and abatement
  • Start building the main concrete structure for the Parliament Welcome Centre

2030 to 2031

  • Substantial completion

Project spotlight

Each quarter, we highlight an element of work being done on the Centre Block or Parliament Welcome Centre.

Central entry

Located in the heart of Canada’s Parliamentary Precinct, the new Parliament Welcome Centre will feature a welcoming entry that will be seamlessly integrated into the central staircase and other key heritage features of the landscape, such as the front lawn and the Vaux Wall.

In addition to making Canada’s Parliament both more secure and more accessible to all Canadians and international visitors, the new underground Parliament Welcome Centre will connect the Centre, East and West Blocks to create an integrated parliamentary complex.

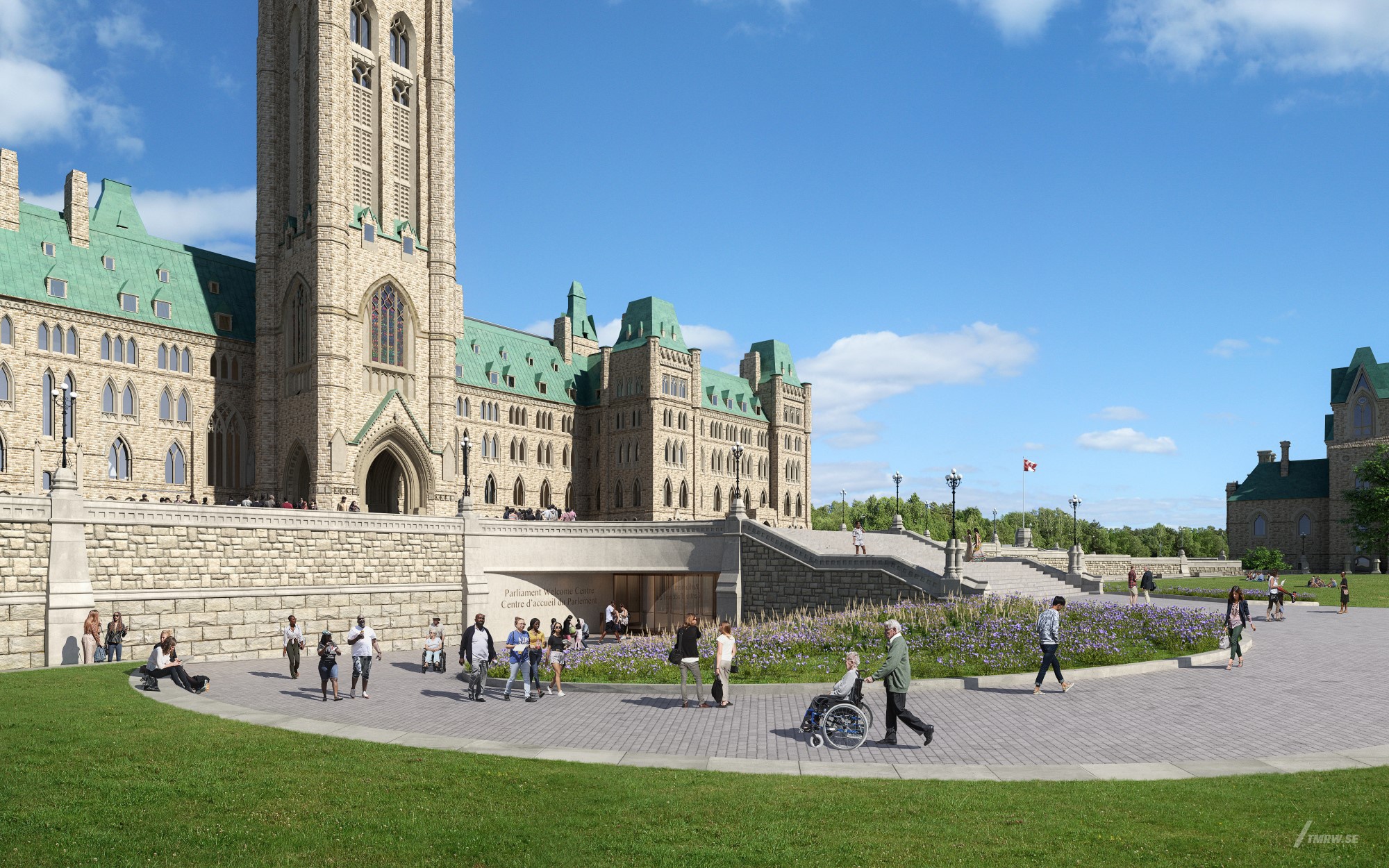

View enlarged image of a computer drawing of a pathway leading to an entrance under stone stairs in front of the Centre Block.
